OQGN and PDO Specification Testing: Your Gateway to Oman's Oil and Gas Market
- 3 minutes ago
- 21 min read
OQGN and PDO specification testing is the gateway question that keeps pipe manufacturers, steel suppliers, and EPC contractors up at night when they're eyeing projects in Oman's lucrative oil and gas sector. You're not alone if you've looked at OQ Gas Networks' carbon steel line pipe requirements or PDO's stringent material specifications and wondered how to navigate the qualification maze. Here's the reality—Oman's energy sector doesn't accept shortcuts. Either your materials meet OQGN and PDO specifications with proper third-party verification, or you're watching opportunities go to competitors who got their testing right.
TCR Engineering has been the testing partner for major OQGN and PDO projects, conducting HIC, SSCC, and CTOD testing that meets both OQGN Doc. No: G14-PD-PL requirements and PDO specifications SP-2347 (Carbon Steel Line Pipes), SP-2337 (Materials Selection for Oil and Gas Production Systems), and SP-2161 (Materials Selection & Corrosion Control for Surface Facilities). TCR has undertaken approved testing for critical OQGN projects including Line Pipe for the 42" Fahud-Sohar Second Loop Line and Line Pipe for Gas Supply to Marsa LNGB, working with manufacturers like Jindal Saw and Man Industries. For PDO-related projects, TCR has served clients including Galfar Engineering & Contracting SAOG, Oman and Tsingshan Steel Pipe Co. Ltd, China. With PDO approval, JSRS certification, and approved procedures from both OQGN and PDO, TCR Engineering has positioned itself as the technical bridge between manufacturers and Oman's demanding oil and gas projects.
The technical work at TCR Engineering is led by Avinash Tambewagh, Technical Head, who oversees all testing operations ensuring adherence to OQGN and PDO specifications. Ashwant Singh, Assistant General Manager, handles project management activities and serves as the interface with clients, Third Party Inspection Agencies (TPIA), PDO, and OQGN. This combination of deep technical expertise and project coordination has enabled TCR to successfully deliver testing services for some of Oman's most critical pipeline infrastructure projects.
Ashwant Singh puts it plainly: "Oman's oil and gas sector represents one of the most professionally managed procurement ecosystems in the region. When we work with clients on OQGN or PDO qualification, we're not just running tests—we're helping them navigate a system where technical excellence, proper documentation, and understanding of local requirements all matter equally. Our JSRS certification and PDO approvals didn't happen overnight. They represent years of building credibility with Omani operators and proving that our testing stands up to the same scrutiny as facilities in Europe or North America.
With Avinash's technical leadership ensuring every test meets specification requirements and my focus on coordinating with TPIAs and client stakeholders, we've built a track record on OQGN projects like the Fahud-Sohar Second Loop Line and Marsa LNGB gas supply infrastructure that manufacturers can rely on."
Why JSRS Certification Changes Everything for Oman Market Access
Before diving into the technical testing requirements, let's talk about the commercial reality that many Indian suppliers miss. The Joint Supplier Registration System (JSRS) in Oman isn't optional—it's the mandatory gateway for participating in procurement with 30+ operators and major EPC contractors in Oman's energy sector.

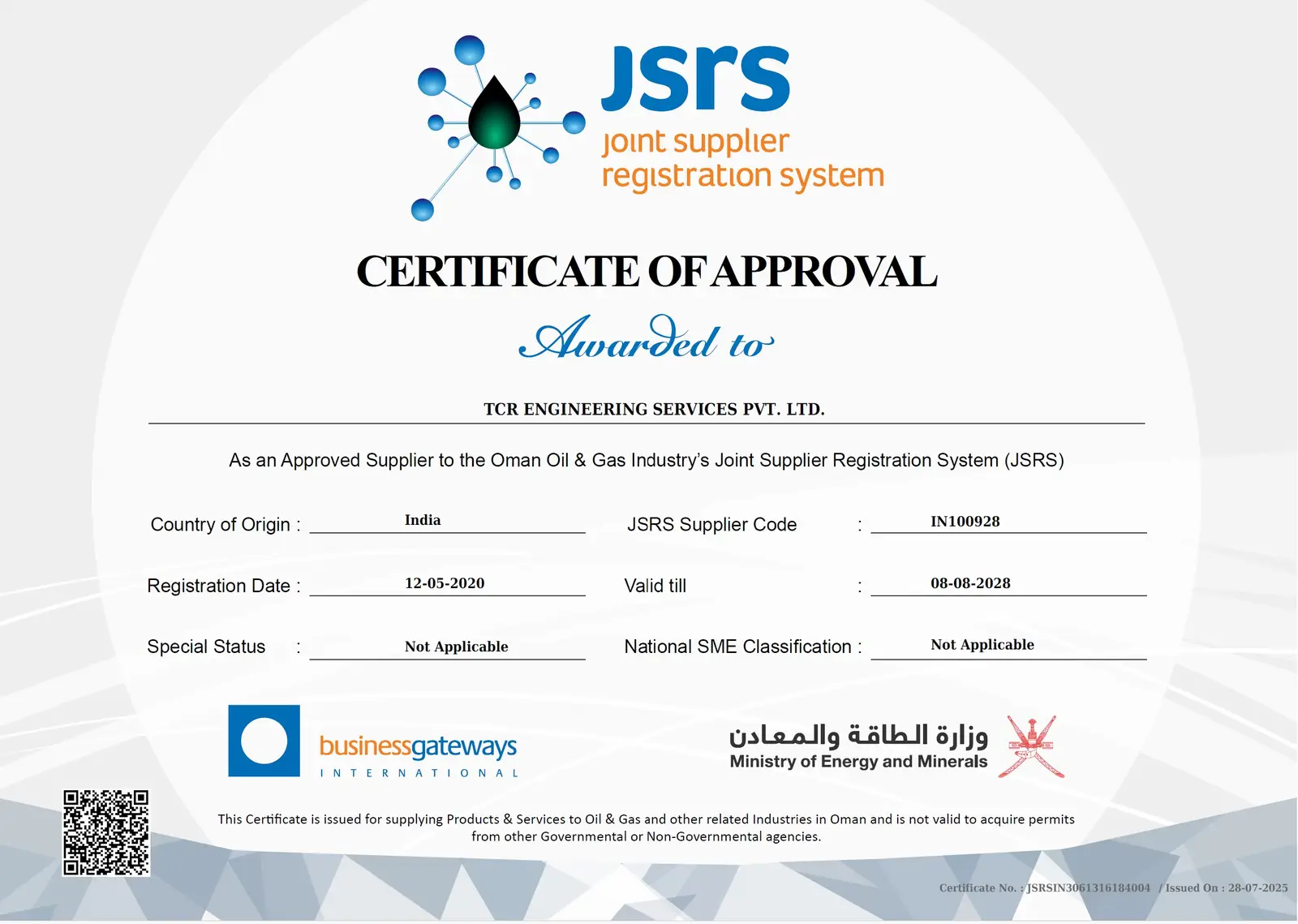

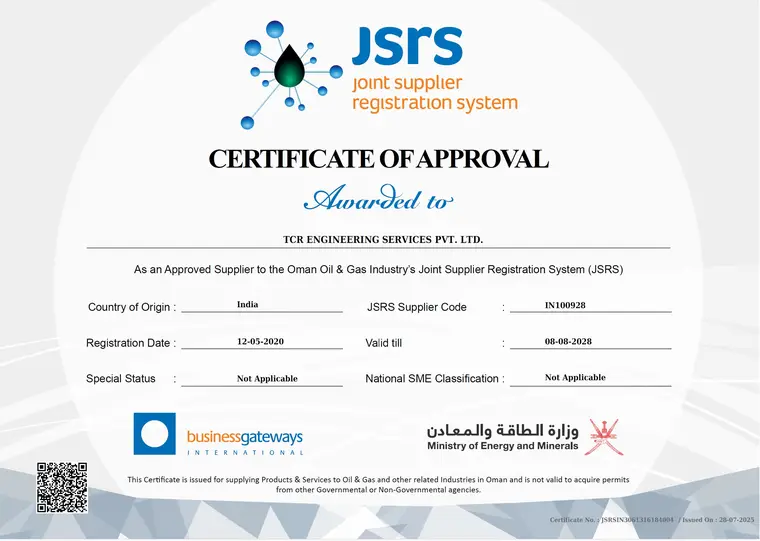

TCR Engineering holds JSRS registration, which provides several critical advantages for clients. When a pipe manufacturer works with TCR for OQGN or PDO testing, they're not just getting test reports. They're getting reports from a JSRS-certified facility that Omani operators recognize and trust. That three-year JSRS certificate acts as a verified seal of credibility that opens doors in a market where reputation and compliance matter as much as competitive pricing.

The JSRS system integrates with Oman's In-Country Value (ICV) initiatives, prioritizing certified companies for contracts that support local economic development. For Indian manufacturers, having testing done through a JSRS-certified lab like TCR Engineering strengthens their overall proposal when bidding on Oman projects.
Understanding OQGN's Carbon Steel Line Pipe Requirements
OQ Gas Networks' specification for carbon steel line pipe, documented as G14-PD-PL (Version 1, issued May 5, 2024), sets rigorous standards for materials used in Oman's gas infrastructure. This specification applies specifically to Submerged Arc Longitudinal Welded (SAWL) carbon steel line pipes manufactured to API 5L 46th Edition PSL 2 (Product Specification Level 2) for pipe sizes 16 inches and above. The specification makes significant amendments to API 5L that manufacturers must understand and comply with.
What catches many manufacturers off guard is that OQGN's specification isn't just API 5L with minor tweaks. It's a comprehensive document that supplements and modifies API 5L requirements specifically for both sour service and non-sour service applications in Oman's onshore gas transmission systems. The specification explicitly excludes offshore pipelines and covers only single-seam SAWL pipes manufactured by JCOE or UOE process—double-seam welded pipes aren't permitted.

TCR Engineering's work on major OQGN infrastructure projects demonstrates the type of comprehensive testing required. The company has successfully completed HIC and SSCC testing for Line Pipe for the 42" Fahud-Sohar Second Loop Line and Line Pipe for Gas Supply to Marsa LNGB. These projects involved working with manufacturers like Jindal Saw and Man Industries, where every heat of steel, every welding procedure, every diameter and grade needed verification across multiple test parameters. Projects like the 42-inch Fahud-Sohar Second Loop Line represent the scale and criticality of OQGN infrastructure where material failure isn't just expensive—it's potentially catastrophic.
Pipe Grades and Delivery Conditions—More Restricted Than Standard API 5L
OQGN's specification covers pipe grades from L245/B through L450/X65 in three delivery conditions: Normalizing or normalizing-rolled (N suffix), Quenched and tempered (Q suffix), and Thermomechanical rolled (M suffix). For sour service, steel grades additionally require an "S" suffix—so you're looking at designations like L360NS, L415QS, or L450MS depending on grade and delivery condition.
Here's where manufacturers need to pay attention. For non-sour service, delivery condition is restricted to thermomechanical rolled only, and steel grades up to X70M are permitted. But for sour service, the requirements become significantly more stringent. Intermediate grades aren't allowed—you must select from the specific grades listed in OQGN's Table 1. This eliminates the flexibility some manufacturers rely on when working to standard API 5L specifications.
Manufacturing Procedure Qualification—The Entry Barrier Many Manufacturers Underestimate
OQGN requires comprehensive Manufacturing Procedure Qualification Testing (MPQT) that must be completed before production starts. The qualification involves selecting three completely finished pipes at random from at least two different heats from the first day's production. The Manufacturing Procedure Specification (MPS) must cover the process for each pipeline diameter, wall thickness, and grade in the purchase order scope.
This isn't optional documentation that gets checked occasionally. Any change to essential manufacturing process parameters beyond the qualification limits requires complete requalification. TCR Engineering's approved procedures align with these MPQT requirements, understanding that the qualification represents a significant investment but is essential for OQGN acceptance.
The MPQT testing requirements specified in OQGN Table 18 are extensive. Every MPQT pipe undergoes the full battery of tests—chemical analysis (both ladle and product analysis), tensile testing (pipe body, weld seam, and all-weld specimens), CVN impact testing (pipe body, weld, and HAZ), guided bend testing, hardness testing, macrographic and metallographic examination with Vickers hardness, CTOD testing for base metal, weld, and HAZ, HIC testing, and SSC testing using four-point bend method. For sour service qualification, passing all these tests isn't negotiable.
HIC Testing—The First Filter for Sour Service Materials
Hydrogen Induced Cracking testing following NACE TM0284 is where many carbon steel pipes either prove their suitability for sour service or get rejected. OQGN's specification is unambiguous—pipes that have not been intentionally manufactured to be HIC resistant steel shall not be used, even if they subsequently pass HIC tests. This means the steel itself must be made with clean steelmaking practices from the start, not just tested and hoped to pass.

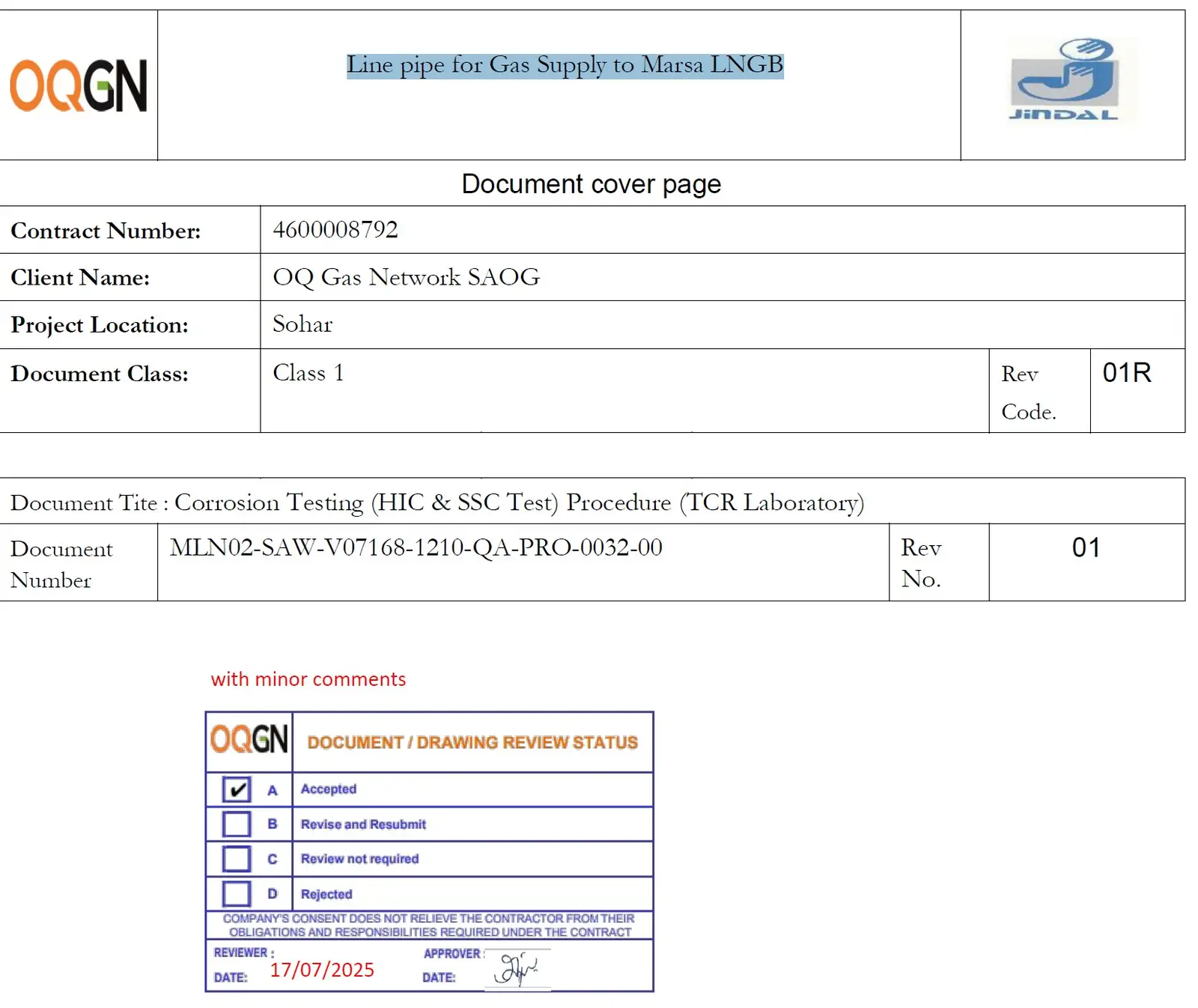

TCR Engineering conducts HIC testing following TCR's approved procedures that align with both OQGN requirements and PDO specifications. The test exposes three specimens per pipe (one across the weld, one at 90 degrees from the weld, and one at 180 degrees from the weld) to H2S-saturated solution (NACE Solution A with 5% sodium chloride and 0.5% acetic acid) for 96 hours at ambient temperature and pressure. After exposure, specimens are sectioned and metallographically examined to measure crack dimensions.
The acceptance criteria from OQGN is specific and unforgiving. Crack Length Ratio (CLR) must not exceed 15%, Crack Thickness Ratio (CTR) must stay below 5%, and Crack Sensitivity Ratio (CSR) needs to be under 2%. Additionally, the maximum individual crack length parallel to rolling direction on any section cannot exceed 5mm. If any section shows vertical cracks perpendicular to rolling direction greater than 0.5mm, the pipe is deemed to have failed with no retesting permitted.
What Ashwant emphasizes to clients is the control sample requirement and the testing frequency. Every HIC test includes a control specimen that must exhibit a minimum average CLR of 20%. If the control fails to meet this, the entire test is deemed invalid and must be repeated. The testing frequency for production is one test from each of the first three heats (or until three consecutive heats meet the acceptance criteria), and subsequently one pipe from every ten heats. For any HIC failure during production, no retesting is permitted—the failed heat is rejected, and additional testing of adjacent heats (one before and one after the failed heat) is required.
The steelmaking requirements behind HIC resistance are equally stringent. OQGN requires steel produced in basic oxygen or electric arc furnace using low sulfur and low phosphorus refining, continuous casting only, fully killed and vacuum degassed, calcium treated for inclusion morphology control, with ASTM grain size number 7 or finer per ASTM E112. For coils/plates with sulfur content of 0.001% and higher, calcium treatment must be applied with calcium content not exceeding 3 times the sulfur content. The inclusion content measured per ASTM E45 method (D) must achieve severity level 1 and be stated in the Material Test Certificate.
SSCC Testing—The 720-Hour Truth Test
Sulphide Stress Corrosion Cracking testing using the four-point bend method (NACE TM0177/ASTM G39 per NACE TM0316) is where materials prove they can handle the combined effect of tensile stress and H2S environments. This isn't a quick verification—it's a full 720-hour (30-day) exposure under constant stress in H2S-saturated solution.
TCR Engineering's SSCC testing capability, approved by both PDO and OQGN, uses calibrated four-point bend fixtures that apply precise stress levels to specimens. OQGN's specification is very specific about stress levels—specimens must be stressed to a minimum of 80% of Actual Yield Strength (AYS) or 95% of Specified Minimum Yield Strength (SMYS), whichever is higher. The specimens remain under this stress while immersed in NACE TM0177 Solution A saturated with H2S at controlled temperature.
The test procedure requires meticulous environmental control. The solution pH must start between 2.7-3.3 (with initial pH of 2.7±0.1 before purging, which may increase but not exceed 3.3 after purging) and shouldn't exceed 4.0 at test completion. H2S concentration needs verification by iodometric titration at test start, after 24 hours, weekly during the test, and at completion, maintaining a minimum of 2,300 ppm throughout. The dissolved oxygen content must be below 50 ppb for low-alloy steels (≤552 MPa) and below 10 ppb for low-alloy steels >552 MPa and corrosion-resistant alloys.
Specimen dimensions for fully machined four-point bend specimens are 115mm length x 15mm width x 5mm thickness (greater than these minimum dimensions). One set of three test specimens is taken from base metal (machined transverse to pipe axis) and one set of three specimens from weld metal (containing the longitudinal seam weld in the middle of the tested area, oriented transverse to the weld seam). Samples are flattened prior to machining test pieces from the inner surface of the pipe wall thickness.
After 720 hours, specimens are inspected under low-power microscope at 10X magnification for surface-breaking fissures or SSC cracks on the tension surface. The occurrence of any surface-breaking fissures or SSC cracks on the tension surface constitutes failure. For unfractured specimens, magnetic particle inspection or dye penetrant inspection may be conducted to detect any subsurface cracking that visual examination might miss.
Here's what many manufacturers miss—for any SSC test failure during MPQT, all pipes produced as part of that MPQT are rejected. There's no retesting option. This makes proper steel selection, controlled manufacturing processes, and rigorous quality control essential before attempting SSC qualification.
Ashwant points out that SSCC testing timelines need to be built into project schedules from the start. With 30 days of exposure plus specimen preparation, environmental monitoring, evaluation time, and potential metallographic examination, clients are looking at 35-40 working days minimum from sample receipt to final report. Trying to compress this timeline compromises the validity of results.
CTOD Testing—Fracture Toughness for Welded Pipe
CTOD (Crack Tip Opening Displacement) testing evaluates fracture toughness of welded pipe, which is critical for OQGN's large-diameter line pipe applications. The test determines whether materials have adequate resistance to brittle fracture, particularly in the weld metal and heat-affected zone where welding can alter microstructure and reduce toughness.
TCR Engineering conducts CTOD testing following ISO 15653, ISO 12135, or BS 7448-1 standards, which align with OQGN's specification requirements. The test uses Bx2B (thickness x 2 x thickness) through-thickness notched SENB (Single Edge Notch Bend) specimens prepared from pipe sections. Three valid specimens are required from each location being tested—pipe base metal, weld metal, and heat-affected zone.
The specimen preparation and orientation requirements specified by OQGN are exacting and cannot be compromised. For weld metal testing, the notch axis must be located on the weld centerline. For HAZ specimens, the notch axis is positioned to sample the fusion line, with the central 50% portion of the specimen thickness sampling the HAZ and the outer portions sampling weld metal. Base metal specimens are taken at location 180 degrees from the weld seam and have position YX per OQGN Figure 10 (X parallel to rolling direction, Y transverse to rolling direction). Test pieces for weld metal and HAZ area are taken from position NP (N normal to weld direction, P parallel to weld direction).
Fatigue pre-cracking is performed at room temperature to create a sharp natural crack, with the crack length controlled between 0.45W to 0.70W (where W is specimen width). The specification requires that no part of the fatigue pre-crack front shall be closer to the crack starter notch than 1.3mm or 2.5% W, whichever is larger. The actual CTOD test is conducted at 0°C or the minimum design temperature specified in the datasheet, whichever is less.
The acceptance criteria specified by OQGN is clear—the minimum CTOD value from a set of three specimens from each location (pipe, weld, HAZ) must be 0.2mm when tested at 0°C or minimum design temperature. Materials that don't meet this threshold lack adequate fracture toughness for the application.
Post-test, specimens are broken open and the fracture surface examined to measure the actual crack length at nine points across the crack front per ISO 12135. The initial crack length a0/W must be within the range 0.30W to 0.70W. The difference between any one of the central seven points and the nine-point averaged value shall not exceed 0.10 times a0. This detailed crack measurement, combined with the load versus crack mouth opening displacement data, provides complete characterization of material fracture behavior.
What manufacturers often don't realize is that CTOD testing for OQGN is required only once during MPQT—it's not part of the routine production testing. However, that single MPQT qualification must demonstrate adequate fracture toughness across all three locations, and failure to meet the 0.2mm requirement in any location means the entire manufacturing procedure fails qualification.
CVN Impact Testing and Hardness Limits—The Day-to-Day Quality Verification
While CTOD testing happens during MPQT qualification, Charpy V-Notch (CVN) impact testing is part of routine production testing with a frequency of once per test unit of not more than 100 pipes. OQGN's specification provides detailed requirements based on fluid category and pipe wall thickness.
For pipe body testing on full-size specimens, the requirements vary by fluid category. Category A applications require minimum average absorbed energy of 27J up to X65 with minimum individual of 21J. Category B & C require 40J average (34J individual). Category D & E require 54J average up to X60, increasing to 60J for X65 and X70 grades, with 50J minimum individual. For pipes with wall thickness above 20mm, testing is performed at MDMT (Minimum Design Metal Temperature) minus 10°C, whichever is less as specified in the datasheet.
Additionally, for a set of three test pieces, the shear fracture area must meet stringent requirements—minimum average of 85% and individual of 75%, based on test temperature of 0°C or minimum design temperature, whichever is less.
The weld and HAZ CVN testing follows the same absorbed energy requirements as pipe body, with testing performed on both weld metal and heat-affected zone at the same temperature conditions. The values for longitudinal direction testing must be at least 50% higher than values required in transverse direction.
Hardness testing requirements for sour service are equally specific. Vickers hardness tests per ISO 6507-1 are carried out on each test piece taken for metallographic examination, with indentation in the HAZ starting as close to the fusion line as possible. The resulting Vickers hardness value at any point shall not exceed 248 HV10 for material grade up to X65. This hardness limit applies to pipe body, weld metal, and HAZ. Any hard spot larger than 50mm in any direction with hardness exceeding 275 HV10 for material grade up to X65 is classified as a defect requiring treatment per API 5L Annex C provisions.
Manufacturing Requirements That Go Beyond Standard Pipe Mills
OQGN's specification includes manufacturing requirements that many standard pipe mills don't routinely follow. All pipes must be mechanically cold expanded for full length, with the sizing ratio (sr) measured on circumference not less than 0.008 or more than 0.015. This cold expansion requirement isn't optional—it's mandatory for every pipe, and the sizing ratio must be recorded once per test unit of not more than 100 pipes.
Jointers are explicitly prohibited and not permitted under any circumstances. Tack welds must be made by automatic welding process using continuous single pass only—intermittent tack welding of the SAWL groove is not permitted. Any repair in tack welds must be performed before start of submerged arc welding of the longitudinal seam.
For non-destructive testing, OQGN requires 100% ultrasonic inspection of the weld seam using automatic ultrasonic equipment (AUT) following ISO 10893-11 to acceptance level U2. The equipment must have automatic spray paint marking and acoustic warnings activated when areas give unacceptable ultrasonic indications or upon de-coupling. Any indication above 50% (approximately 6 dB) of the reference level and loss of coupling in excess of 10 dB from good coupling situation must be marked as an indication and registered.
The reference standards for weld seam UT contain specific machined notches—two longitudinal notches at weld seam edge on both ID and OD (N5 type notch of 0.05t x 50mm x 1mm depth), one transverse notch across the weld seam on ID and OD, and a 1.6mm diameter through-thickness hole drilled in the center of the weld seam. These reference indicators establish the sensitivity for detecting imperfections.
For pipe ends, the weld seam at each end for a minimum distance of 200mm must be inspected by radiographic method, with results recorded on film or recordable imaging medium. The same area is also inspected using UT, which is taken as the prime inspection method. If a defect is detected by any NDT method, it's considered rejected—the final acceptance is by UT, and RT cannot be used to accept defects detected by UT.
Wall thickness measurement requirements are particularly stringent. No negative tolerance is considered in the wall thickness value provided in the datasheet/scope of supply. The wall thickness of each pipe is checked along circumference at both ends and at mid-location at 12 o'clock, 3 o'clock, 6 o'clock, and 9 o'clock positions. If the manufacturer requires plus tolerance for wall thickness, it must be increased to maintain the applicable tolerance range—but negative tolerance from specified wall thickness isn't accepted.
PDO Specifications—Similar Requirements, Different Context
While OQGN focuses primarily on gas transmission infrastructure, PDO (Petroleum Development Oman) specifications cover oil and gas production, processing systems, and injection systems across PDO's extensive operations. TCR Engineering's PDO approval and experience with clients like Galfar Engineering & Contracting SAOG and Tsingshan Steel Pipe Co. Ltd. demonstrates the facility's capability to handle both OQGN and PDO requirements.

PDO's specification framework consists of three key documents that manufacturers must understand. SP-2347 (Procurement Specification for Carbon Steel Line Pipes) provides amendments and supplements to API 5L 46th Edition specifically for PDO applications. SP-2337 (Materials Selection for Oil and Gas Production Systems) supplements ISO-21457 with PDO-specific requirements for production equipment, vessels, piping, and utility systems. SP-2161 (Materials Selection & Corrosion Control for Surface Facilities) supplements DEP 39.01.10.12-Gen with PDO's specific corrosion control and materials requirements.
What makes PDO specifications challenging is the integration across these documents. A manufacturer qualifying carbon steel line pipe must comply with SP-2347's manufacturing and testing requirements while also meeting the materials selection criteria in SP-2337 and the corrosion control requirements in SP-2161. Ashwant Singh coordinates this multi-specification compliance for TCR's clients, ensuring that testing addresses all applicable PDO requirements.
PDO SP-2347 has specific requirements that go beyond standard API 5L. The specification requires steel plates/coils sourced from PDO approved steel mills (AVME 17.1.2), pipes manufactured at PDO approved pipe mills with valid API license and monogram (AVME List 6.1), and all testing conducted at PDO approved laboratories (AVME MCI-121) or ISO 17025 certified facilities with prior PDO approval. TCR Engineering's presence on the PDO approved laboratory list means manufacturers don't face additional qualification hurdles when using TCR for their testing.
For HIC testing, PDO SP-2347 aligns with SP-2161 requirements but adds specific provisions. Testing must be carried out at PDO approved labs or ISO 17025 accredited facilities with prior approval from PDO Materials and Corrosion TA2. The acceptance criteria matches OQGN (CLR ≤15%, CTR ≤5%, CSR ≤2%), with maximum individual crack length parallel to rolling direction not exceeding 5mm and vertical cracks perpendicular to rolling direction greater than 0.5mm constituting failure. Control samples must exhibit minimum average CLR of 20%, and retesting is not allowed for failures.
For SSCC testing, PDO specifications require qualification using four-point bend test method per ASTM G39/NACE TM0177. The applied stress must be at minimum 80% of Actual Yield Strength (AYS) or 95% of Specified Minimum Yield Strength (SMYS), whichever is higher—slightly different from some other specifications. Test duration is 720 hours (30 days) with no cracks or rupture accepted. If SSC test fails during Manufacturing Procedure Qualification Testing (MPQT), all pipes produced as part of that MPQT are rejected.
Avinash Tambewagh's technical oversight ensures TCR's testing procedures align with these nuanced PDO requirements. The difference between 80% AYS or 95% SMYS (PDO) versus 90% SMYS or 80% AYS (some other specs) might seem minor, but using incorrect stress levels invalidates qualification testing and wastes months of effort and significant cost.
The Documentation Trail That Actually Matters
One aspect that Ashwant stresses to every client is that Oman projects live and die by documentation. Having materials that meet specifications is necessary but not sufficient. The testing needs to be documented in formats that OQGN and PDO recognize, with traceability from heat numbers through sampling, testing, and reporting.

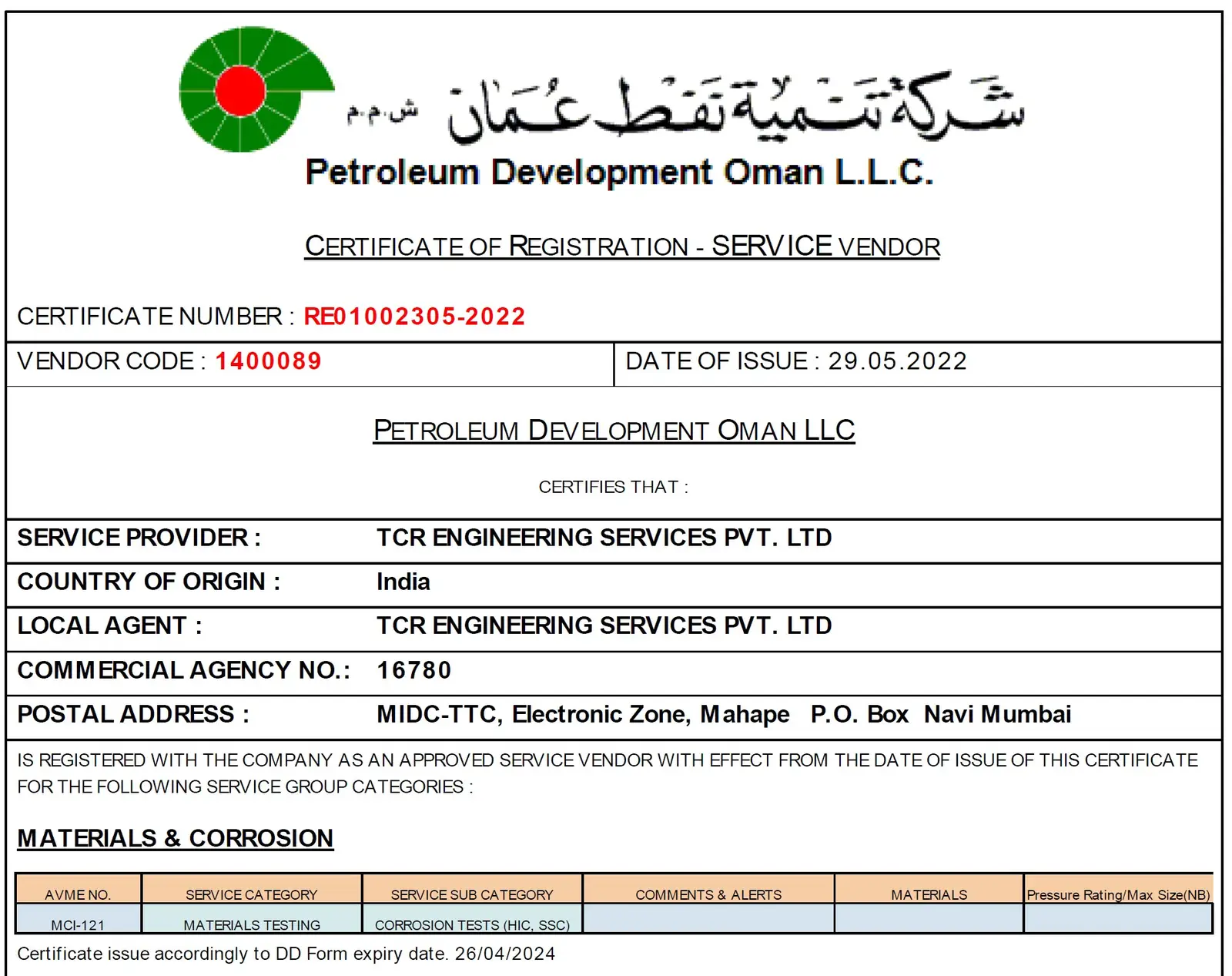

TCR Engineering's procedures have been approved by both OQGN and PDO, meaning the test reports follow formats these organizations accept without back-and-forth clarifications. Each report includes complete environmental parameters (solution composition, pH measurements, gas concentrations, temperature records), specimen identification and traceability, detailed test results with supporting data, and photographic documentation where required.
For CTOD testing, this includes the load versus displacement curves, nine-point crack measurements, post-test metallography showing microstructure at the crack location, and confirmation that all validity criteria were met. For HIC testing, metallographic images of all sections showing crack measurements are included. For SSCC, the complete stress application documentation and environmental monitoring records are part of the deliverable.
Questions Manufacturers Ask When Targeting Oman Projects
Do we need JSRS certification ourselves, or can we work through TCR's certification?
Manufacturers bidding directly on OQGN or PDO projects will eventually need their own JSRS registration. However, when working through approved vendors or contractors who already have JSRS, the testing lab's JSRS certification provides the necessary credibility for test reports. TCR Engineering can guide clients on when direct JSRS registration becomes necessary versus when working through existing certified channels makes more sense.
Can testing be witnessed by OQGN or PDO representatives?
Yes, and for qualification testing on major projects, witnessing is often required. TCR Engineering coordinates with Third-Party Inspection Agencies (TPIA) who represent OQGN or PDO during critical testing activities. The facility is set up to accommodate witness points for specimen preparation, test setup, test execution, and results documentation.
How do OQGN requirements compare to API or ASTM standards we're familiar with?
OQGN's G14-PD-PL specification is based on API 5L 46th Edition but makes significant amendments and additions. While it references familiar NACE and ASTM standards (NACE TM0284 for HIC, NACE TM0177 for SSCC, ISO 15653/ISO 12135 for CTOD), OQGN has specific acceptance criteria, sampling requirements, manufacturing controls, and documentation expectations that go well beyond baseline API 5L requirements. For example, OQGN prohibits jointers, requires specific cold expansion ratios (0.008-0.015), mandates automatic tack welding only, specifies 248 HV10 maximum hardness for up to X65 grade, requires grain size number 7 or finer, and has detailed NDT requirements with specific reference standards. TCR Engineering's approved procedures incorporate all these OQGN-specific requirements that standard API 5L procedures don't address.
What's the typical timeline for complete qualification testing?
For a new pipe product requiring HIC, SSCC, and CTOD testing across multiple heats and diameters, plan on 45-60 working days minimum. HIC testing takes roughly 10-12 working days, SSCC needs 35-40 days, and CTOD requires 25-30 days. These can overlap for different specimens, but the critical path typically runs through SSCC testing duration.
Can we use test results from other labs, or does everything need to be done at TCR?
For PDO and OQGN work, testing generally needs to be done at an approved facility following approved procedures. TCR Engineering's PDO approval and OQGN-approved procedures mean tests conducted at TCR are directly accepted. Results from other labs may require additional verification or may not be acceptable depending on the specific project requirements.
What happens if materials fail one of the tests?
Failed tests require root cause investigation. Sometimes it's a genuine material issue requiring heat treatment adjustment, chemistry modification, or welding procedure changes. Other times it might be related to specimen preparation or sampling location.
Avinash Tambewagh's technical team works with clients to understand failure modes and identify potential corrective actions, while Ashwant coordinates with TPIAs and OQGN/PDO authorities on the path forward. However, retesting isn't automatic—materials need to be corrected before retesting makes sense. For PDO SP-2347 and OQGN specifications, certain failures (like HIC) don't permit retesting at all—the failed heat is rejected outright.
How does pricing compare to labs in Oman or international testing facilities?
TCR Engineering's pricing is typically more competitive than international labs while maintaining equivalent technical standards. The combination of JSRS certification, PDO approval, approved procedures, and local accessibility makes TCR an attractive option for manufacturers, particularly those based in India or the region.
What about testing for stainless steels or corrosion-resistant alloys?
While carbon steel line pipe represents the bulk of OQGN work, TCR Engineering's capabilities extend to stainless steels and CRAs. The SSCC testing procedures accommodate different material classes with appropriate stress levels and environmental conditions. CTOD testing for higher-strength or higher-toughness materials follows the same ISO standards with adjusted specimen sizes and acceptance criteria.
Does OQGN require API monogram on pipes?
Yes, absolutely. OQGN specification explicitly requires that the manufacturer must have a valid license to use API Monogram, and line pipes supplied to this specification must bear API monogram in accordance with requirements of API 5L Annex A and Annex H for Product Specification Level PSL 2. This isn't optional—it's a fundamental requirement. Manufacturers without valid API 5L PSL 2 monogram licensing cannot supply to OQGN specification regardless of their technical capabilities or testing results.
The Oman Market Reality Beyond Testing
Ashwant frequently reminds clients that successful entry into Oman's oil and gas market requires more than passing tests. The market values long-term relationships, consistent quality, reliable delivery, and professional engagement. Vendors who view OQGN or PDO projects as one-off opportunities often struggle. Those who invest in understanding Omani operators' expectations, maintain quality systems that ensure consistent material properties, and build relationships with local partners tend to succeed long-term.
The JSRS system itself reflects this philosophy—it's designed to identify suppliers who can perform consistently over a three-year certification period, not just deliver once and disappear.
Working with TCR Engineering for Oman Projects
For manufacturers looking at OQGN or PDO opportunities, TCR Engineering provides both technical testing expertise and project coordination that streamlines the qualification process. Avinash Tambewagh, Technical Head, leads all testing operations—from specimen preparation through final evaluation—ensuring every test meets the exacting requirements of OQGN and PDO specifications. Ashwant Singh, Assistant General Manager, handles project management activities including client interface, Third Party Inspection Agency (TPIA) coordination, and liaison with PDO and OQGN authorities.
This division of responsibilities has proven effective on major projects including OQGN's 42" Fahud-Sohar Second Loop Line and Gas Supply to Marsa LNGB, as well as various PDO projects. For Galfar Engineering & Contracting SAOG's PDO work and TSINGSHAN STEEL PIPE CO. LTD's manufacturing qualification, Ashwant coordinated the complex logistics of TPIA witnessing, specification compliance documentation, and stakeholder communication while Avinash ensured the technical testing delivered results that met specification acceptance criteria.
The workflow typically starts with specification review where both Avinash and Ashwant work with the client to understand exactly which tests are required, what acceptance criteria apply, how many heats or batches need testing, and what the project timeline looks like. Avinash provides technical guidance on sampling procedures to ensure specimens are representative and properly prepared. Ashwant coordinates testing schedules to meet project milestones, arranges TPIA witness points, and manages documentation flow.
During testing execution, Avinash's team conducts the actual HIC, SSCC, and CTOD testing following TCR's PDO and OQGN approved procedures. Ashwant manages client communication, addresses TPIA queries, and ensures all quality hold points are properly observed. Results are delivered in OQGN/PDO-accepted formats with all necessary supporting documentation, material test certificates, and traceability records.
For manufacturers working with both Indian pipe mills and Chinese manufacturers, this coordinated approach matters. TSINGSHAN STEEL PIPE CO. LTD needed testing that PDO would accept for their manufacturing qualification—Ashwant's understanding of PDO's approval process and Avinash's technical execution delivered results that passed PDO scrutiny on first submission. Similarly, Galfar Engineering & Contracting SAOG's projects required precise coordination between testing timelines and construction schedules—something Ashwant managed while Avinash ensured testing quality never compromised speed.
Moving Forward with Confidence in Oman Market Entry
At the end of the day, OQGN and PDO specification testing is about more than generating test reports. It's about demonstrating to sophisticated operators in one of the world's most professionally managed oil and gas markets that your materials meet rigorous standards and your quality systems can deliver consistent performance.
TCR Engineering's combination of JSRS certification, PDO approvals, OQGN-approved procedures, and experienced personnel provides manufacturers with credible third-party verification that opens doors in Oman's energy sector. With Avinash Tambewagh's technical leadership ensuring every test meets specification requirements and Ashwant Singh's project coordination handling the complex interface with clients, TPIAs, PDO, and OQGN, manufacturers get both technical excellence and professional project management.
TCR's track record speaks for itself—from OQGN's critical 42" Fahud-Sohar Second Loop Line and Gas Supply to Marsa LNGB projects to PDO projects for clients like Galfar Engineering & Contracting SAOG and Tsingshan Steel Pipe Co. Ltd. Whether you're a pipe manufacturer looking at your first OQGN project, a steel mill wanting PDO qualification, or an EPC contractor needing testing coordination for Oman work, having a testing partner who combines Avinash's technical depth with Ashwant's project coordination experience makes the difference between successful qualification and missed opportunities.
If you're targeting projects in Oman's oil and gas sector and need comprehensive HIC, SSCC, and CTOD testing that OQGN and PDO actually accept, TCR Engineering's proven performance on critical infrastructure projects like the Fahud-Sohar Second Loop Line and Marsa LNGB gas supply infrastructure demonstrates the kind of support that gets manufacturers qualified and keeps them qualified. Because in Oman's energy market, there are no shortcuts to technical credibility, and OQGN and PDO specification testing done right is how you establish that credibility.
Contact TCR Engineering for OQGN and PDO Testing
For detailed information about OQGN and PDO specification testing, approved procedures, JSRS certification, specimen requirements, or to schedule testing for your Oman projects, contact Ashwant Singh, Assistant General Manager (Project Management & Client Interface), at TCR Engineering Services Pvt. Ltd., VKB House, EL-182 MIDC-TTC Electronic Zone, Mahape, Navi Mumbai, Maharashtra 400710, India. Tel: +91 22 6738 0901/902. Email: sales@tcreng.com. With Avinash Tambewagh leading technical operations and Ashwant managing project coordination with TPIAs, PDO, and OQGN, TCR Engineering continues to be the testing partner that manufacturers trust for Middle East oil and gas qualification.
