+91 98335 30200  ·  sales@tcreng.com
The underside of a long concrete box-girder viaduct, piers marching into cold mist

Industries

Infrastructure

Structural Audit and Subsurface Investigation

The Statue of Unity was tested through construction with L&T, and Mumbai's civic bridges are now surveyed by underwater robots. Between the two sit GPR and UPV subsurface mapping, pavement evaluation and statutory structural audit.

Request a Quote

In brief

TCR tests, inspects and audits roads, bridges, tunnels and civic structures across India: more than 500 bridges assessed across India through robotic NDT, structural audit and rehabilitation engineering, and the Statue of Unity tested through construction with L&T.

Key takeaways

  • 10 asset groups, from national highways and expressways to stadiums and public buildings, and 7 families of damage mechanism are covered below.
  • Bridge inspection is reported against IRC SP 35, IRC SP 18 and IRC SP 40; the full standards matrix is below.
  • 7 marquee engagements are documented on this page, among them the BMC robotic underwater inspection programme covering over 400 bridges from March 2026.

Overview

TCR investigates distress in bridges, flyovers, highway structures and ageing reinforced concrete, and delivers robotic and underwater bridge inspection with structural audit.

  • Structures covered: bridge, flyover and highway-structure distress, foundation settlement, and corrosion in ageing reinforced concrete.
  • Mechanisms: carbonation- and chloride-induced reinforcement corrosion, prestress-tendon stress corrosion cracking and grout voids, fatigue at steel connections, and bearing and expansion-joint failure.
  • Governing practice: IRC SP 35 for inspection and maintenance of bridges, IRC SP 18 for inventory and condition survey, and IRC SP 40 for rehabilitation.

Industry Context

Infrastructure spending has reached a scale where asset condition is an investment-grade question. NHAI recorded its highest-ever capital expenditure in FY25 and monetised built assets through InvIT and toll-transfer structures in the same year.

  • Why monetisation changes the brief: institutional investors buying twenty-year concessions demand independent, documented evidence of structural condition, not the builder's assurance.
  • Pipeline: CRISIL projects sustained infrastructure spending across FY24 to FY30.
  • Roads: the Ministry of Road Transport and Highways and NHAI capex, around 12,000 km of national-highway construction a year at peak, the Bharatmala Pariyojana programme, a steady backlog of bridge and ROB/RUB construction, and state highway and rural road work under the Pradhan Mantri Gram Sadak Yojana.
  • Urban and monumental: municipal roads, water supply, sewerage and street lighting, Section 353B structural audit across Mumbai's ageing building stock, and the Statue of Unity and Statue of Oneness programmes.
  • Emerging scope: structural-steel testing for solar-PV mounting structures on highway-corridor land, foundation and structural verification for electric-vehicle charging stations on national highways, hydrogen-storage and pressure-vessel work for hydrogen fuel stations on trucking corridors, and sub-water bridge-pier inspection driven by climate-resilience and scour-mitigation spending.

Independent evidence of condition is what TCR supplies: more than 500 bridges inspected, including underwater robotic scope, statutory structural audits, GPR and UPV subsurface mapping, pavement evaluation, and NABL-accredited materials testing behind every number reported.

Plant Sections We Inspect

ClusterEquipment / Material
National Highway and ExpresswayPavement (flexible bituminous, rigid concrete), embankment, sub-grade, cross-drainage works
State and District RoadPavement, ROB / RUB, culvert, side drain
Bridges and ViaductsBox girder (segmental and cast-in-place), composite girder, cable-stayed and arch, prestressed concrete sleepers and girders, bearings, expansion joints, deck slabs
Sub-water bridgeBridge pier (concrete and steel tubular), abutment, intake structure, jetty pile; inspected by ROV under the BMC underwater programme of over 400 bridges
TunnelNATM and TBM, segmental lining, waterproofing membrane, drainage system
Monumental ConstructionReinforced-concrete shell, steel cladding, structural-steel core, foundation engineering
Structural AuditBuildings older than 30 years (Section 353B), heritage structures, industrial sheds, gantry rails, plant buildings
Drainage and Civic InfrastructureManhole and gully top per BS EN 124-5 up to 900 mm; sewer; storm-water drain
Urban Civic AssetReinforced-concrete water tank, elevated service reservoir (ESR), ground service reservoir (GSR), pumping-station shell
Stadium and Public BuildingReinforced-concrete shell, steel canopy, foundation, post-tensioned slabs

Damage Mechanisms We Investigate

CategoryMechanisms
PavementRutting, cracking, ravelling, pothole, shoving, longitudinal cracking, transverse cracking, alligator cracking
Bridge concreteReinforcement corrosion (carbonation-driven, chloride-driven), prestress loss, alkali-silica reaction (ASR), delayed ettringite formation (DEF), creep and shrinkage, freeze-thaw
Bridge steelHAZ embrittlement, weld toe cracking, fatigue at riveted connections, corrosion under coating, thermal-cycling fatigue at expansion joints
BearingWear, corrosion, frozen bearing, neoprene ageing, PTFE wear
Building structural auditReinforcement corrosion, concrete spalling, plaster delamination, settlement-induced cracking, slab punching shear, beam-column joint deterioration
Sub-water bridgeSplash-zone corrosion, submerged-zone corrosion, scour-induced settlement
DrainageManhole and gully top fatigue, sewer line corrosion, sub-grade settlement at trench reinstatement

Standards Coverage Matrix

Bridge
IRC SP 35 (inspection and maintenance of bridges); IRC SP 18 (inventory and condition survey); IRC SP 40 (rehabilitation of bridges); IRC 6 (loads and load combinations on bridges); IRC 22 (composite construction); IRC 78 (foundations and substructures); BS 5400; AASHTO LRFD Bridge Design Specifications; Load Testing of Bridges, Eva Lantsoght (2019); FHWA Bridge Inspector's Reference Manual (2022).
Pavement and Road
IRC 37 (flexible pavement design); IRC 58 (rigid pavement design); IS 73 (paving bitumen); IS 1206 (penetration); IRC SP 53 (modified bitumen); MoRTH Specifications for Road and Bridge Works.
Concrete
IS 456; IS 1343 (prestressed); IS 516 (Part 5/Sec 1):2018 (UPV); IS 516 (Part 5/Sec 4):2020 (rebound hammer); ASTM C39, C496, C617, C876 (half-cell potential), C1383 (impulse-echo); ACI 318, ACI 224 (cracking).
Reinforcement and HT Strand
IS 1786; IS 14268; ASTM A615, A416; ACI 318.
Structural Steel
IS 800 (general construction in steel); IS 1893 (criteria for earthquake-resistant design); AISC 360; AWS D1.1 (structural welding); AWS D1.5 (bridge welding).
Tunnel
IS 4880 (criteria for design of tunnels conveying water); EN 1990 (Eurocode); FHWA Tunnel Design Guidelines.
Drainage

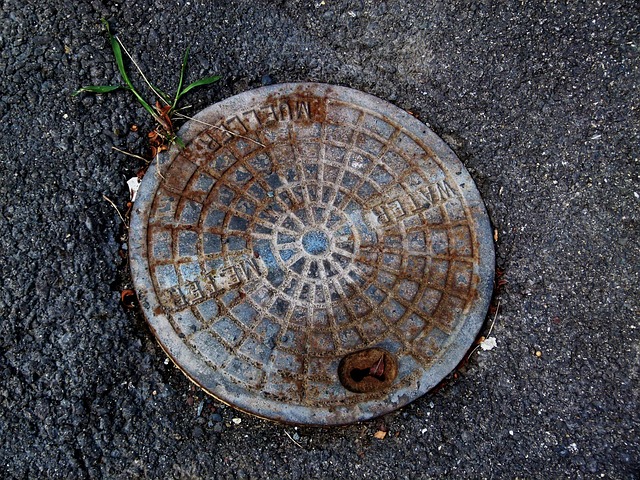

BS EN 124-5 (manhole and gully top fatigue); IS 1726 and IS 12592 (cast iron and precast concrete manhole covers).
Structural Audit
Structural audit under Section 353B of the Mumbai Municipal Corporation Act 1888; BIS guidance.
Grout Fatigue
CEB-FIP Model Code 1990 / 2010, for grout fatigue testing of post-tensioned and prestressed systems.

Service Applications Across the TCR Continuum

For infrastructure, TCR’s five-stage service model follows the life of a built asset: materials qualification, construction quality assurance, in-service condition assessment, repair and rehabilitation, and residual life engineering.

The recurring problems are chloride-induced reinforcement corrosion in coastal structures, alkali-aggregate and sulphate attack, carbonation of ageing concrete, foundation settlement, and the structural distress that accumulates silently until a Section 353B of the Mumbai Municipal Corporation Act 1888 structural audit forces the question. The rehabilitation window is the infrastructure equivalent of a plant turnaround: traffic diversions and occupancy constraints put a cost on every day. Procurement risk sits in cement, aggregate, reinforcement, coupler and bitumen quality across a fragmented supply base. TCR Engineering covers all five stages from its NABL-accredited civil testing laboratory at Mahape, Navi Mumbai.

Stage One, Materials Qualification (Sourcing and Procurement)
Construction materials are qualified at intake: cement per IS 4031, aggregates per IS 2386, concrete mix design support, TMT reinforcement per IS 1786, reinforcement couplers per IS 16172 under the BIS-accredited programme, structural steel, bitumen and road materials, soil and geotechnical investigation, and water quality for construction, with sampling by the TCR-branded pickup van across the Mumbai Metropolitan Region.
Stage Two, Construction Quality Assurance (Construction and Commissioning)
During construction, TCR provides cube and core testing per IS 516, non-destructive concrete evaluation by ultrasonic pulse velocity per IS 516 (Part 5/Sec 1):2018 and rebound hammer per IS 516 (Part 5/Sec 4):2020, welding inspection of structural steel per IS 800 and AWS D1.1, theodolite-based plumbness and straightness surveys on towers and piers, anchor and fastener pull-out testing, and pavement evaluation on road projects, building the baseline record for the asset.
Stage Three, In-Service Condition Assessment
On operating assets, TCR delivers structural audits under Section 353B of the Mumbai Municipal Corporation Act 1888, bridge inspection per Indian Roads Congress codes and the Federal Highway Administration Bridge Inspector's Reference Manual methodology, half-cell potential and carbonation surveys for reinforcement corrosion, ground penetrating radar and subsurface mapping, and thermography of building services, converting visual distress into measured condition.
Stage Four, Repair and Rehabilitation (Shutdown and Turnaround Equivalent)
In the rehabilitation window, TCR supports distress mapping and repair specification, cathodic protection of reinforced concrete (see Civil & Structural Testing), load testing of strengthened members, quality assurance on repair materials including micro-concrete and grouts, and post-repair verification by the same non-destructive methods that found the distress, so the intervention is proven, not assumed.
Stage Five, Residual Life Engineering (Continuum)
The engineering stage delivers residual life assessment of structures, structural integrity assessment, failure and collapse investigation, engineering design review of strengthening schemes, and the durability studies, chloride profiles, mix optimisation, and coating evaluation, that feed the specification for the next asset.

Named Clients

TCR’s infrastructure clients are government and public-sector bodies, Indian EPC contractors, real-estate developers, cement and concrete producers, metro operators, the owners of monumental structures, and international project references. Across them the scope covers structural audit, concrete and building-material testing, high-tensile strand and rebar-coupler qualification, and bridge NDT.

India Government and PSU
National Highways Authority of India (NHAI); Ministry of Road Transport and Highways (MoRTH); Public Works Department (Maharashtra PWD; a long-running robotic NDT programme); Brihanmumbai Municipal Corporation (BMC; Roads Department registration March 2026 onward, plus the AI-assisted underwater 400+ bridge programme); Mumbai Metropolitan Region Development Authority (MMRDA); CIDCO; Pune Municipal Corporation; State PWDs (Gujarat, Karnataka, Andhra Pradesh, Tamil Nadu, Kerala, Madhya Pradesh, Rajasthan, West Bengal, Odisha); U.P. State Bridge Corporation; Bridge and Roof; RITES (PSU consultancy).
India EPC
Larsen and Toubro Construction; Afcons Infrastructure; HCC; Patel Engineering; J. Kumar Infraprojects; Tata Projects; IL&FS Engineering; Reliance Infrastructure; Dilip Buildcon; PNC Infratech; KNR Constructions.
India Real Estate
Godrej Properties (3-year LRC, all Mumbai Zone, April 2026 onward), Kalpataru, Shapoorji Pallonji, Rustomjee, Lodha, Oberoi, K. Raheja, DLF, Prestige, Brigade.
Cement and Concrete
JSW Cement; UltraTech; Heidelberg Cement.
Metro Operator
Mumbai Metro One.
India Monumental Construction
Larsen and Toubro for Statue of Unity (Sardar Vallabhbhai Patel); Adi Shankaracharya Statue of Oneness (Madhya Pradesh); Antilia (Mumbai); Wankhede Stadium redevelopment.
International
Haramain High Speed Rail (Mecca-Medina, through the TCR Arabia joint venture; see Railways); Master Gas System bridges and crossings (Pipelines & City Gas).

Marquee Projects

The infrastructure record runs to more than 500 bridges across India, the BMC robotic underwater programme covering over 400 bridges from March 2026, and full mechanical, chemical, metallurgical and non-destructive verification through construction at the Statue of Unity. Project, service anchor and year follow.

ProjectService AnchorYear
500+ bridges across IndiaRobotic NDT, structural audit, rehabilitation recommendationContinuous
BMC March 2026 robotic underwater bridge programme400+ bridges, AI-assisted underwater inspectionMarch 2026 onward
Statue of Unity, Larsen and ToubroMechanical, chemical, metallurgical, NDT through constructionConstruction era
Statue of Oneness, Adi ShankaracharyaConventional NDT for structural fabricationMultiple
Mumbai Coastal Road ProjectCivil testing, sub-water bridge-pier and abutment inspectionContinuous
Godrej Properties 3-year LRC, all Mumbai ZoneLong-Term Rate Contract for materials testing across Godrej propertiesApril 2026 onward
Kalpataru, Shapoorji Pallonji, RustomjeeLong-Term Rate Contracts for property-development testingContinuous

High-tensile strand for prestressed bridge decks, Mumbai and Pune flyovers and high-speed-rail viaducts is qualified for tensile, stress-relaxation and 2 million-cycle fatigue per IS 14268, ASTM A416 and ISO 15630-3.

Documents

Download the reference documents for this page. Every file is hosted on this domain and is also listed in the site document library.

  • BMC Roads Department Registration (valid to March 2028)

    Client approval, Brihanmumbai Municipal Corporation. Extension letter No. Dy. Ch. Eng./1571/Rds./Plg. dated 22 September 2026 extends the registration of the Mahape material testing laboratory, granted u/no. Dy.Ch.E./4469/Rds./Plg. dated 25 March 2026, to 24 March 2028 against NABL certificate NABLT0726MH18640 valid to 2 March 2030. The registration certificate, its permitted test scope and its conditions follow the letter in the same file.

    PDF (661 KB)

  • CIDCO Approval Letter

    City and Industrial Development Corporation of Maharashtra approval for materials and civil testing

    PDF (2.4 MB)

  • RITES

    RITES Ltd Western Region enlists TCR's Mahape laboratory on its approved laboratory list. No. RITES/WR Lab/TCRE, 18 September 2020, signed by H. S. Prasad, Senior Deputy General Manager (Lab).

    PDF (487 KB)

  • L&T - Mumbai Metro

    L&T-STEC Joint Venture audit of TCR's Navi Mumbai materials testing laboratory under the project quality plan for Mumbai Metro Line 3, package UGC-01, contract MM3-CBS-UGC-01 for MMRC. Audit notification 8 March 2021, audit conducted 16 March 2021, with the audit summary report.

    PDF (3.0 MB)

  • Mumbai Coastal Road Project

    AECOM Asia Company Limited, General Consultants for the Mumbai Coastal Road Project, reviews TCR Engineering Services as third-party testing laboratory for Package II, the Baroda Palace to Worli end of the Bandra-Worli Sea Link. Ref MCR2/GCC/220/LL/201515, 31 May 2021.

    PDF (82 KB)

Related insights

17 published insights on this site carry the Infrastructure tag. The 6 most recent are below.

Read all 17 Infrastructure insights →

Frequently asked questions

How many bridges has TCR inspected?

More than 500 bridges have been assessed across India through robotic NDT, structural audit and rehabilitation engineering, and the BMC programme from March 2026 adds AI-assisted robotic underwater inspection across 400-plus bridges, with sub-water pier and abutment work continuing on the Mumbai Coastal Road Project.

What did TCR test at the Statue of Unity?

TCR carried the mechanical, chemical, metallurgical and non-destructive verification through construction of the Statue of Unity with Larsen and Toubro, a year-long onsite engagement, and delivered conventional NDT for structural fabrication at the Adi Shankaracharya Statue of Oneness.

Which bridge inspection codes does TCR follow?

Bridge work runs per IRC SP 35, IRC SP 18 and IRC SP 40, with loads per IRC 6, alongside BS 5400, AASHTO LRFD and the FHWA Bridge Inspector's Reference Manual methodology, converting visual distress into measured condition for owners and investors.

Can TCR test HT strand for bridges and viaducts?

Yes. High-tensile strand for prestressed bridge decks, Mumbai and Pune flyovers and high-speed-rail viaducts is qualified for tensile, stress-relaxation and 2 million-cycle fatigue per IS 14268, ASTM A416 and ISO 15630-3, with grout fatigue testing per CEB-FIP Model Code 1990 / 2010.

Does TCR perform structural audits on ageing buildings?

Yes. Structural audits run under Section 353B with half-cell potential and carbonation surveys, ground penetrating radar, ultrasonic pulse velocity and rebound hammer per IS 516 (Part 5), thermography, and residual life certification, producing the condition evidence municipal authorities and societies require.

Inspect the structure before the load finds the flaw.

Request a Quote
Chat on WhatsApp
