+91 98335 30200  ·  sales@tcreng.com
A single drilling derrick silhouetted at the edge of a wide desert horizon at dusk

Industries

Oil and Gas Upstream

Sour Service Qualification to NACE TM0177

Tubing, risers and trees are qualified against H2S here: SSC and HIC testing to NACE TM0177 Methods A through D, with active laboratory approvals at Saudi Aramco, ADNOC and Petroleum Development Oman.

Request a Quote

Overview

TCR is on ONGC’s approved-laboratory register since 1998, First Article Qualification for the world’s wellhead OEMs, and the sour-service bench that qualifies tubing, risers and trees against NACE MR0175/ISO 15156 (materials for use in H2S-containing environments in oil and gas production); NACE MR0103 (for refining-adjacent service, cross-vertical); NACE TM0177-2016 Methods A through D (laboratory testing of metals for resistance to SSC and SCC in H2S environments).

Key takeaways

  • 7 plant sections and 7 damage mechanisms covered on this page, from Onshore production to Wellhead Equipment Verification.
  • Reported against Sour Service. NACE MR0175 / ISO 15156 (materials for use in H2S-containing environments in oil and gas production); NACE MR0103 (for refining-adjacent service, cross-vertical); NACE TM0177-2016 Methods A through D (laboratory testing of metals for resistance to SSC and SCC in H2S environments); full standards coverage matrix below.
  • 14 marquee engagements documented on this page; 33 published technical insights tagged to this sector.

Overview

TCR holds ONGC’s QAD approval Serial No. 01, the very first name on the list, held continuously since 1998, and runs First Article Qualification for Cameron, NOV, Halliburton, Schlumberger, Baker Hughes and Weatherford, with active approvals at Saudi Aramco, Dangote and PDO.

  • Longest approval: ONGC QAD approval Serial No. 01, the first name on the list, held continuously since 1998.
  • First Article Qualification: Cameron, NOV, Halliburton, Schlumberger, Baker Hughes and Weatherford.
  • Active approvals: Saudi Aramco, Dangote and PDO.
  • Equipment covered: wellhead hardware, tubing, risers, manifolds and offshore platforms.
  • Mechanisms: sour-service cracking (SSC, HIC, SOHIC), CO2 and H2S corrosion, sand-cut and slug erosion, riser and vibration fatigue, and weld-toe defects.

POTENTIAL FAILURES WE SERVICE: Leaks, blowdowns and equipment failures across wellhead hardware, tubing, risers, manifolds and offshore platforms. TCR analyses sour-service cracking (SSC, HIC, SOHIC), CO2 and H2S corrosion, sand-cut and slug erosion, riser and vibration fatigue, and weld-toe defects, plus First Article Qualification on new wellhead equipment at the manufacturing source.

Industry Context

Upstream operators carry inspection obligations at both ends of the asset life. Ageing fields and sour service drive integrity spend during operation, while decommissioning sits on the balance sheet as a formal asset retirement obligation under Ind AS and IFRS, with the worldwide oil and gas decommissioning liability independently estimated at USD 311 to 362 billion.

  • Why spend sits at both ends of asset life: ageing fields and sour service drive integrity spend during operation, while decommissioning sits on the balance sheet as a formal asset retirement obligation.
  • Indian operators: ONGC, Oil India, Cairn Oil and Gas, Reliance KG-D6 and Vedanta, with the ONGC empanelment the single longest active vendor relationship.
  • GCC and MENA: Saudi Aramco, ADNOC, PDO, OQGN, KOC, Qatar Energy, KNPC, the Iraqi Ministry of Oil and PetroChina International Iraq, through TCR Arabia.
  • Oilfield services and OEMs: Halliburton, Schlumberger, Cameron International, NOV, Baker Hughes, Weatherford and GE International, sourcing verification testing and First Article Qualification.
  • Scope line held: storage tanks, pressure vessels, separator and slug catcher, manifold piping and wellhead-adjacent fixed equipment; not rotating-equipment field service.
  • Emerging scope: CO2 enhanced oil recovery in the Indian onshore basins (Bombay High, Cambay, Krishna-Godavari, Cauvery) and CCUS at offshore platforms.

Between those two poles sits a continuous demand for materials qualification, corrosion testing, and fitness for service judgement. TCR's sour-gas laboratory runs SSC, HIC, and SOHIC programmes to NACE and ISO 15156 against Petroleum Development Oman, Saudi Aramco, and ONGC/EIL specifications, and the group's FFS and failure analysis bench converts inspection findings into defensible run, repair, or retire decisions.

The upstream oil and gas vertical splits across three buyer pools:

The Indian onshore and offshore operator pool (ONGC, Oil India, Cairn Oil and Gas, Reliance KG-D6, Vedanta) anchors the long-tenure relationships, with TCR's ONGC empanelment representing the single longest active vendor relationship in the company's history.

The GCC and MENA upstream pool (Saudi Aramco, ADNOC, PDO, OQGN, KOC, Qatar Energy, KNPC, Iraqi Ministry of Oil, PetroChina International Iraq) carries the volume of cross-border and field-services-adjacent work via TCR Arabia and TCR Advanced.

The international oilfield-services and equipment-OEM pool (Halliburton, Schlumberger, Cameron International, NOV Inc., Baker Hughes, Weatherford, GE International) sources verification testing, First Article Qualification, and audit-grade material certification.

The static-equipment specialist line is held: TCR is the laboratory and integrity bench for storage tanks, pressure vessels, separator and slug catcher, manifold piping, and wellhead-adjacent fixed equipment, not a rotating-equipment field service contractor.

The CO2 EOR (enhanced oil recovery) trend in the Indian onshore basins (Bombay High, Cambay, Krishna-Godavari, Cauvery) brings supercritical CO2 piping and reservoir-tie-in qualification work. CCUS at offshore platforms brings cross-vertical scope with Pipelines and Marine. Hydrogen blending in natural-gas trunklines brings API 941 HTHA discipline and ASTM F519 / API 20E hydrogen embrittlement bench into upstream operator-side scope. The decommissioning agenda (legacy offshore platforms, idle wells, abandoned pipelines) brings structural assessment and material recovery scope.

TCR is the laboratory and integrity bench for the sour and sweet service surface area, the wellhead-equipment First Article Qualification stream, and the Aramco-grade ECA and RT capability that the upstream vertical demands.

Plant Sections We Inspect

ClusterEquipment
Onshore productionWellhead and Christmas tree (statutory inspection scope), separator (HP, MP, LP), test separator, slug catcher, manifold, gas dehydration (TEG, MEG), produced-water treatment, gas compressor station
Offshore productionTopsides separator and process train, riser and J-tube, jacket structure (cross-vertical with Marine), subsea manifold tie-in (cross-vertical with Pipelines), boat landing
Storage and StabilisationCrude and condensate stabilisation column, storage tanks (API 650, API 620 where low-pressure), spheroids
Gas ProcessingAcid-gas removal (amine, MEA, MDEA), dehydration (TEG glycol, mol-sieve), NGL extraction (turbo-expander section), LPG fractionator
Sour ServiceSour-crude and sour-gas piping, separator, slug catcher; H2S scavenger system
Pipeline Tie-InWellhead to manifold to gathering, pig launcher and receiver; cross-vertical with Section 11d Pipelines
Wellhead Equipment VerificationCameron International, NOV Inc., Halliburton, Schlumberger, Baker Hughes equipment First Article Qualification testing

Damage Mechanisms We Investigate

CategoryMechanisms
Sour serviceSulphide stress cracking (SSC), hydrogen-induced cracking (HIC), stepwise cracking (SWC), stress-oriented HIC (SOHIC); per NACE MR0175 / ISO 15156
CO2 corrosionSweet (CO2) corrosion, top-of-line corrosion, mesa attack, pitting under deposit
Combined sour and sweetCO2/H2S synergistic corrosion (the AiOM-CCP undersea pipeline case framework)
Erosion-corrosionSand-cut erosion at choke and elbow, slug erosion at riser bend
Mechanical and fatigueVibration-induced fatigue, riser fatigue, dent and gouge from third-party
Material and weldHAZ embrittlement, weld toe cracking, lack of penetration, lack of fusion
Equipment First ArticleManufacturing defect identification at the source-inspection stage

Standards Coverage Matrix

Sour Service
NACE MR0175 / ISO 15156 (materials for use in H2S-containing environments in oil and gas production); NACE MR0103 (for refining-adjacent service, cross-vertical); NACE TM0177-2016 Methods A through D (laboratory testing of metals for resistance to SSC and SCC in H2S environments); NACE TM0284 (HIC); NACE TM0316 (four-point bend); NACE TM0198 (slow strain rate test); EFC Publication 16 (CO2 resistance materials).
RBI / FFS / ECA
API 580 / 581 4th ed. (January 2025); API 579-1/ASME FFS-1 4th ed. (2021); BS 7910; API 1104 22nd ed. (2021) Annex A.
Inspection Codes
API 510, 570, 653; API RP 572, 574, 575; API RP 941 HTHA where hydrogen service is in scope.
Asset Integrity Management
Asset Integrity Management for Offshore and Onshore Structures, M. El-Reedy (1st ed., 2022).
Welding and Material
ASME Section IX 2023; AWS D1.1 2025; API 1104 22nd ed.; API 5L 46th ed.; ASTM A106 (carbon steel piping for high-temperature service); ASTM A335 P22, P11; ASTM A516 Grades 60, 65, 70 (carbon steel pressure-vessel plates); ASTM A537 Class 1 / 2.
Construction
ASME Section VIII Div. 1, Div. 2; ASME B31.3 (process piping); ASME B31.4 / B31.8 (pipeline transportation systems); API 650, API 620.

Service Applications Across the TCR Continuum

Upstream oil and gas buys integrity against sour service.

Hydrogen sulphide partial pressure governs material selection for wellheads, christmas trees, downhole tubulars, flowlines, and separators per NACE MR0175/ISO 15156, and the laboratory evidence behind that selection, sulphide stress cracking, hydrogen induced cracking, and stress-oriented hydrogen induced cracking, is where TCR runs one of the largest sour service testing capacities in India. In operation the problem set widens to carbon dioxide corrosion in flowlines, microbiologically influenced corrosion in water systems, fatigue of structural connections offshore, and erosion in sand-producing wells. Shutdown windows on production facilities are short and weather-bound; procurement risk sits in forgings, seals, and elastomers for high pressure high temperature service. TCR Engineering and TCR Advanced service all five stages of the five-stage Trusted Relationship Model (see Why TCR) for onshore and offshore operators and their equipment manufacturers.

Stage One, Sourcing and Procurement

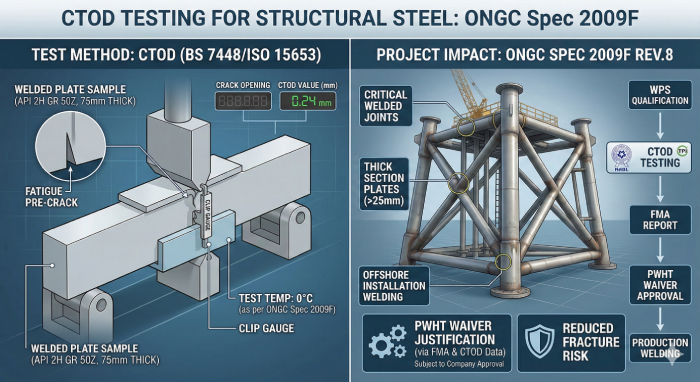

Materials for sour service are qualified through sulphide stress cracking per NACE TM0177-2016 Methods A through D including four-point bend, hydrogen induced cracking per NACE TM0284, stepwise cracking and stress-oriented hydrogen induced cracking, hydrogen embrittlement testing, and NORSOK M-710 qualification of polymers, elastomers, and composites for sour exposure. Forging and valve vendor audits, sample picking, in-production checks, and loading supervision protect the supply chain for wellhead and pressure-control equipment.
Stage Two, Construction and Commissioning
For gathering stations, processing trains, and terminal construction, TCR delivers baseline non-destructive testing on piping and vessels, phased array ultrasonic testing and time of flight diffraction, radiography, welder certification and procedure qualification per ASME Boiler and Pressure Vessel Code Section IX and API 1104, post-weld heat treatment with hardness control for sour service, and positive material identification, establishing the baseline record for each facility.
Stage Three, In-Service
On producing facilities, TCR runs corrosion mapping on separators, knockout drums, and flowlines, thickness monitoring programmes, remote visual inspection of confined and buried equipment, thermography, and risk-based inspection planning per API RP 580 and API RP 581, with integrity operating windows per API RP 584 tied to produced fluid chemistry so inspection intervals track actual corrosivity rather than design assumptions.
Stage Four, Shutdown and Turnaround
In the shutdown window, TCR inspects pressure vessels internally per API 510, exchanger and cooler tube bundles, storage tanks per API 653 including in-service robotic options, flare and relief system components, and structural steel, with in-situ metallographic replication on high temperature components and magnetic particle and penetrant testing on nozzles and attachment welds, supported by turnaround inspection manpower.
Stage Five, Continuum
Findings feed fitness for service per API 579-1/ASME FFS-1 on corroded vessels and piping, engineering critical assessment of flowline and riser girth welds, failure analysis of downhole, wellhead, and surface equipment including seal and elastomer failures, remaining life assessment of ageing facilities, and the materials-selection and contract research studies that qualify equipment for the next field development.

Named Clients

India Public Sector
Oil and Natural Gas Corporation (ONGC; QAD Sr. No. 01 since 1998), Oil India Limited, GAIL India Limited (cross-vertical with Pipelines).
India Private Sector
Reliance Industries (KG-D6), Cairn Oil and Gas (Barmer, Ravva), Vedanta Limited, Adani-Total Energies (Dhamra LNG cross-vertical), Hindustan Oil Exploration Company.
GCC Upstream
Saudi Aramco (Vendor 10040677, ANDT Contract 6601000141), ADNOC, Petroleum Development Oman (PDO; approval refresh May 2022), Oman Gas Network (OQGN), Kuwait Oil Company (KOC), Qatar Energy, KNPC, PetroChina International Iraq FZE; Iraqi Ministry of Oil (approval since May 2019); Baiji Refinery (idle-plant restart project).
International
Shell (multiple geographies, sour-service approved through Shell-approved elastomeric and corrosion testing), BP, ExxonMobil (vendor-side via OEM source inspection), TotalEnergies, Pemex (Mexico).
Equipment OEMs and Oilfield Services
Cameron International (First Article Qualification testing since 2012, ongoing), NOV Inc. (March 2023), Halliburton, Schlumberger, Baker Hughes, Weatherford, GE International (3-year contract December 2012), SABIC Global Contract 4600006798 (vendor 505239).

Marquee Projects

The upstream record begins with ONGC approval Sr. No. 01, held since 1998 and the longest-tenure approval on the books, and runs through sour-service qualification of OQGN line pipe at Jindal SAW Mundra and work for Indorama Eleme Petrochemicals in Nigeria. Project, service anchor and year follow.

ProjectService AnchorYear
ONGC QAD Sr. No. 01 (the longest-tenure approval; original approval letter MRBC/QAD/LAB/97-98/779 dated 25 February 1998)Materials testing, NDT, source inspection across ONGC asset base for ferrous and non-ferrous metals, weld, glass, refractories, ceramics, and radiographySince 1998
Jindal SAW Limited Mundra Kutch for OQ Gas / OQGN Oman line pipeSour-service qualification (HIC per NACE TM0284 plus SSCC four-point bend per NACE TM0177 / ASTM G39 / OQGN docs); PO 4703000416 dated 01.07.2025July 2025 onward
Indorama Eleme Petrochemicals Limited, Port Harcourt, Rivers, NigeriaOlefins furnace tubes condition assessment and NDT (in-situ metallography on SS304H with Aqua-regia etchant for 100 replicas, UCI hardness, permeability measurement, SEM analysis)April 2025 onward
Saudi Aramco Jafurah Gas Compression PlantsECA, PWIS Package-12024 to 2025
Shell sour-service material qualificationNACE TM0177 / TM0284 / MR0175 testing campaignsContinuous
Saudi Aramco Master Gas System (cross-package)ECA per API 1104; L&T, Kalpataru Projects International, GAS Arabian Services deliveryContinuous
Cameron InternationalFirst Article Qualification testing2012 onward
NOV Inc.Approval and source-inspection testingMarch 2023 onward
Halliburton, Schlumberger, Baker Hughes, WeatherfordVendor source-inspection and verification testingContinuous
GE International3-year contract scopeDecember 2012 onward
SABICGlobal Contract 46000067982012 to 2017
Casale SA (Switzerland)SX3000 Vendor Code 1000007973 (urea and melamine licensor; cross-vertical with Fertilisers)June 2025 onward
Petrokemya, KSARLA of fire-steam-tube boiler (cross-vertical with Power)2023
PIC Fertiliser Plant, Kuwait (NBTC delivery)RLA of 120 critical equipment in ammonia and urea plant (cross-vertical with Fertilisers)2024

For Petroleum Development Oman and OQ Gas Networks, TCR qualifies sour-service line pipe to PDO SP-2347 and OQGN G14-PD-PL, with hardness, HIC, and SSC acceptance read against criteria stricter than NACE. CTOD with hydrogen-sulphide pre-charging, developed for Larsen and Toubro, charges specimens for 96 hours in NACE TM0177 Solution A before loading within a 20-minute window.

Storage-sphere, terminal, and transfer-line investigations cover corrosion under insulation, pitting, and stress-corrosion cracking.

Documents

Download the reference documents for this page. Every file is hosted on this domain and is also listed in the site document library.

  • ONGC Approval

    Oil and Natural Gas Corporation Limited, Quality Assurance Division, lists TCR Engineering Services on its Annexure IX list of approved test houses for testing of ferrous and non-ferrous metals, at both the Lower Parel and the Mahape laboratories.

    PDF (491 KB)

  • Saudi Aramco

    Saudi Aramco Consulting Services Department list of approved in-Kingdom third-party testing laboratories, effective 22 June 2020, carrying TCR Arabia at Dammam, vendor 10040677, with approved status.

    PDF (402 KB)

  • PetroChina

    Source-inspection and quality-control documentation naming TCR on the PetroChina Halfaya gas processing plant EPCC contract, detail design package HFY-3800-1600-VED-165-QC-PD-0004.

    PDF (1.1 MB)

  • Qatar Gas

    Qatargas Company Limited, Engineering and Projects, issues the pre-qualification document for TCR Qatar as testing laboratory with approval. Transmittal P-990-T-IWA-QG-TRG-00030, 27 June 2021.

    PDF (1.4 MB)

  • Ministry of Oil (Iraq)

    Ministry of Oil, Republic of Iraq: registration of TCR Engineering as an approved inspection and testing company for the ministry's formations and contractors.

    PDF (78 KB)

  • PDO (Oman)

    Petroleum Development Oman LLC certificate of registration as an approved service vendor in the Materials and Corrosion service group. Certificate RE01002305-2022, vendor code 1400089, issued 29 May 2022.

    PDF (16 KB)

  • Emerson

    Emerson Process Management, Virgo Valves and Controls Private Limited, Pune, confirms complete satisfaction with TCR's testing services and product quality, and records that TCR's results compare favourably with other commercial and industry laboratories. 23 July 2015.

    PDF (161 KB)

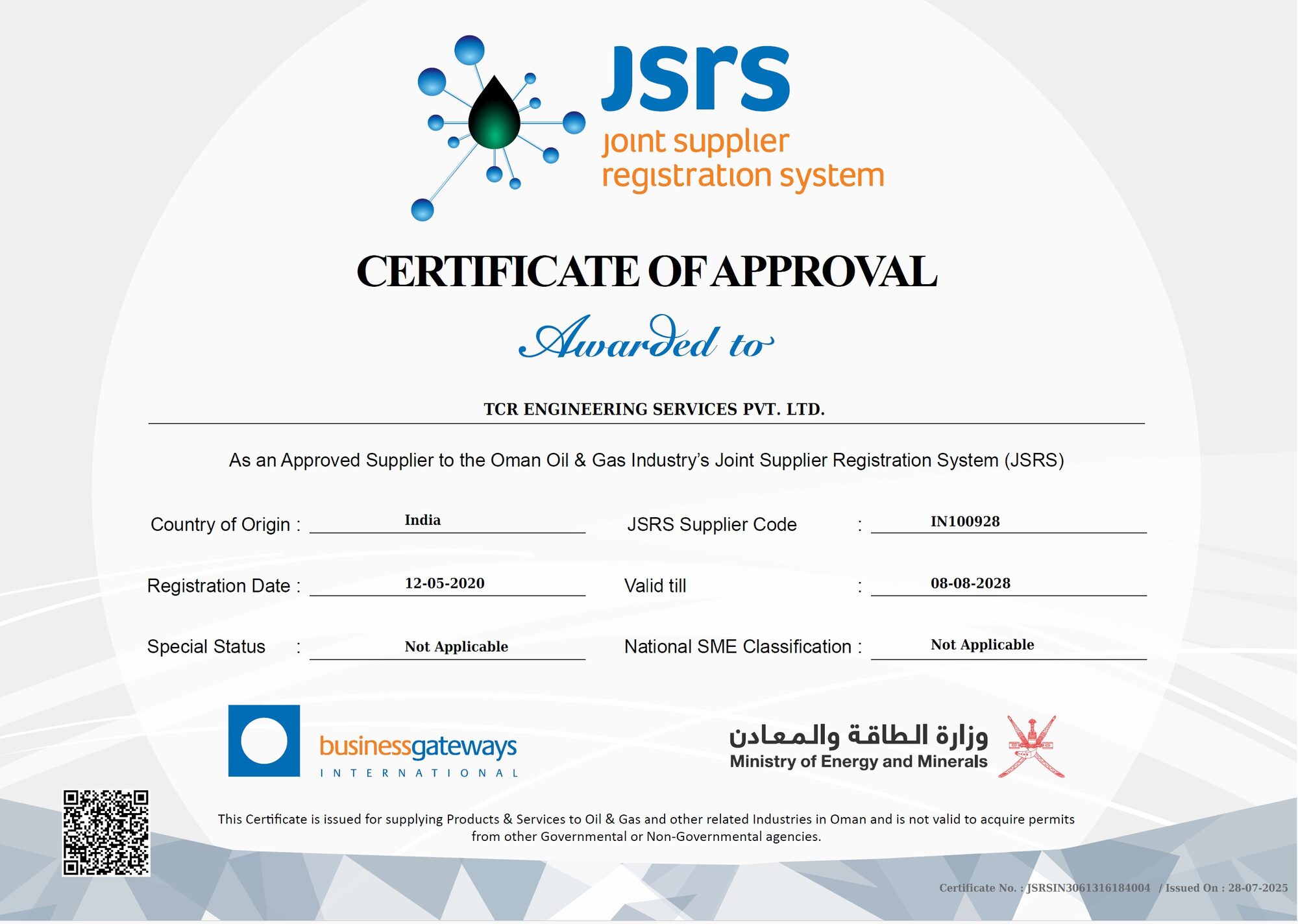

  • Joint Supplier Registration System, Oman: Supplier Certificate to 8 August 2028

    TCR Engineering Services Pvt. Ltd. is a registered supplier to the Oman oil and gas industry under the Joint Supplier Registration System, operated by Business Gateways International for the Ministry of Energy and Minerals. Certificate JSRSIN3061316184004, supplier code IN100928, issued 28 July 2025, valid to 8 August 2028.

    PDF (257 KB)

Related insights

36 published insights on this site carry the Oil & Gas Upstream tag. The 6 most recent are below.

Read all 36 Oil & Gas Upstream insights →

Frequently asked questions

How long has TCR held ONGC approval?

Since 25 February 1998, under original approval letter MRBC/QAD/LAB/97-98/779. TCR is Serial Number 01 on ONGC's approved-laboratory register, the longest-tenure approval on the panel, covering materials testing, NDT and source inspection across ferrous and non-ferrous metals, welds, glass, refractories, ceramics and radiography.

What sour-service testing does TCR run?

Sulphide stress cracking per NACE TM0177-2016 Methods A through D including four-point bend, HIC per NACE TM0284, stepwise cracking and SOHIC, slow strain rate per NACE TM0198, and qualification against NACE MR0175/ISO 15156, read against PDO SP-2347 and OQGN G14-PD-PL acceptance criteria stricter than NACE.

Does TCR perform First Article Qualification for wellhead OEMs?

Yes. Cameron International has run First Article Qualification testing with TCR since 2012, NOV Inc. since March 2023, and Halliburton, Schlumberger, Baker Hughes and Weatherford route vendor source-inspection and verification testing through the same bench, with GE International on a contract from December 2012.

Can TCR run CTOD with hydrogen pre-charging?

Yes. The CTOD programme with hydrogen-sulphide pre-charging, developed for Larsen and Toubro, charges specimens for 96 hours in NACE TM0177 Solution A and loads them within a 20-minute window, serving engineering critical assessment of sour-service girth welds and risers.

Is TCR approved by GCC upstream operators?

Yes. Saudi Aramco lists TCR as Vendor 10040677 with ANDT Contract 6601000141, PDO refreshed its approval in May 2022, and the Iraqi Ministry of Oil has approved TCR since May 2019, with work delivered for ADNOC, OQGN, KOC and Qatar Energy.

Qualify the string for sour service, to NACE MR0175.

Request a Quote
